Fiddle Park Plan

As part of the Town-wide Parks and Recreation Master Plan project, a site master plan for Fiddle Park was created to reimagine the park as a community destination. The Fiddle Park Redevelopment was presented to council as part of the 2025 Draft Budget

⚠️ Page Update in Progress
This page is currently being updated and may not contain all reports, documents, or images at this time. Please check back soon for the most complete and up-to-date information.

Background

Fiddle Park Background 2006-2023

The 2006 Fiddle Park Management Plan was created to guide the development of the park primarily to support tourism and recreational activities in addition to the annual Fiddle Fest event.

In 2009, the Town created the first Town-wide Parks Master Plan for Shelburne.

Planning for the continued evolution of Fiddle Park as a community destination park was also identified through the Town’s Community Improvement Plan (CIP) completed in 2019.

As part of the Town-wide Parks and Recreation Master Plan project, a site master plan for Fiddle Park was created to reimagine the park as a community destination.

Council received the Parks and Recreation Master Plan & Fiddle Park Plan presentations for information on June 26, 2023.

Fiddle Park Vision and Guiding Principles - November 22, 2021

Following review and discussion of the survey results, the project team of Town staff and consultants (GSP) prepared a draft vision statement and guiding principles, as follows:

The Vision and Guiding Principals are intended for Council consideration at this stage, to guide the next steps of the process and overall direction for the Fiddle Park concept plan and may be refined or expanded through further consultation.

Read the full report Fiddle Park Plan – Online Survey Results and Draft Vision & Guiding Principles

Fiddle Park Plan – Council Motions

Fiddle Park Community Engagement 2021-2023

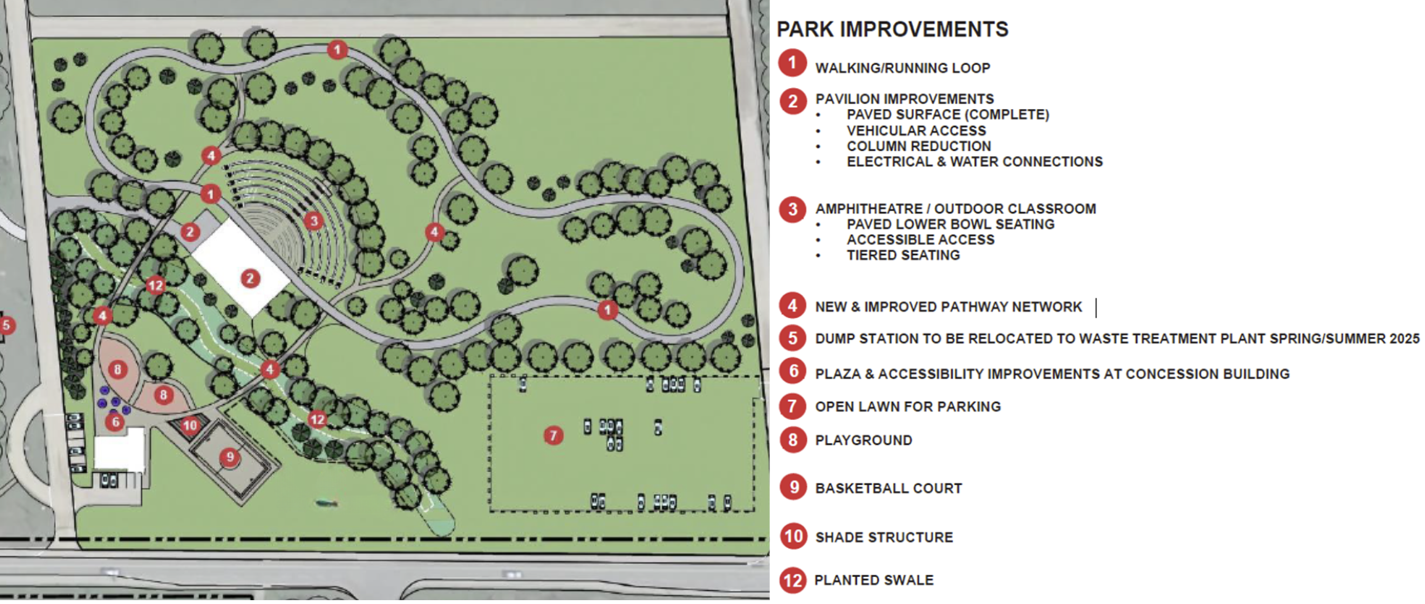

2025 Capital Project

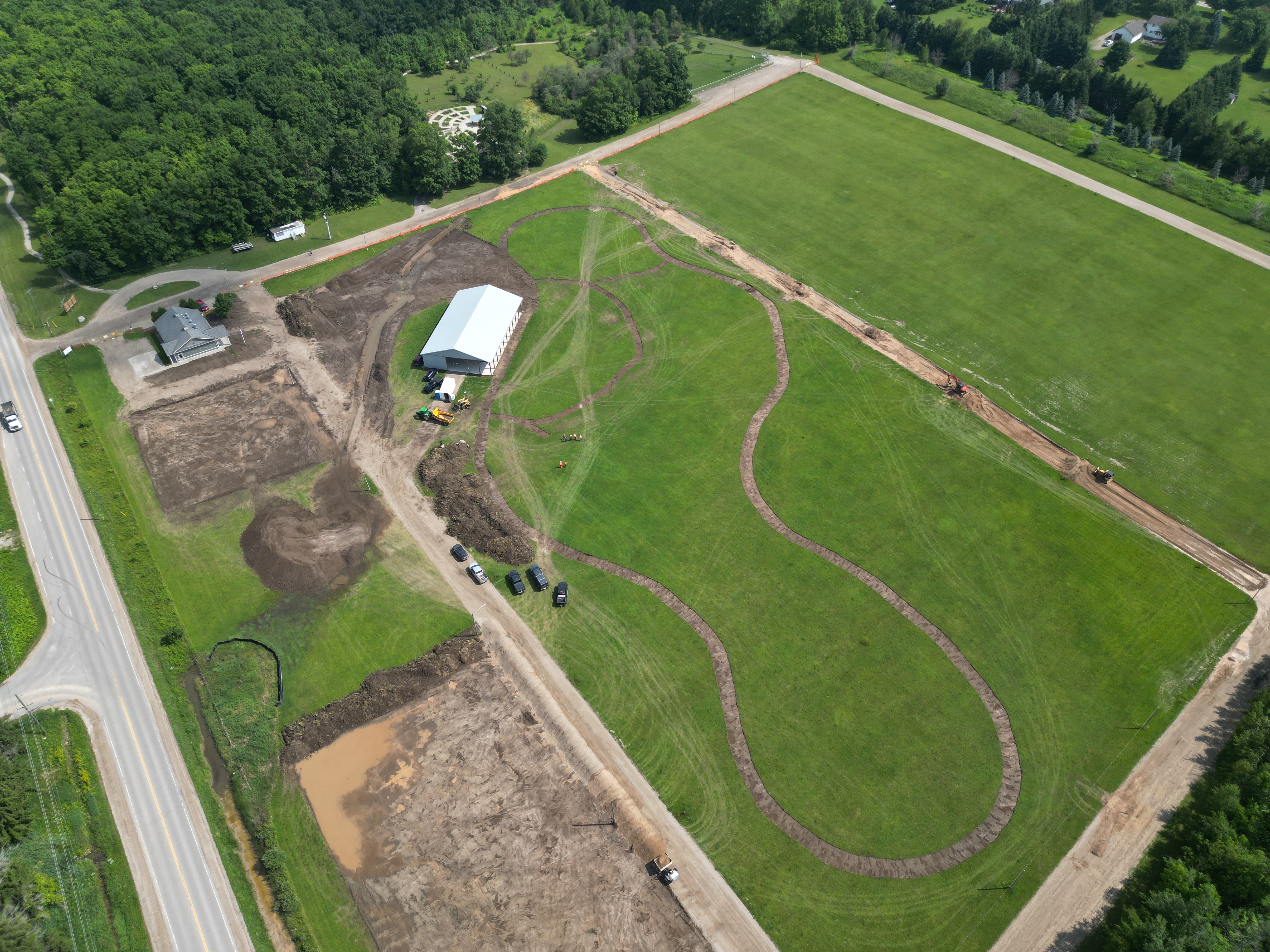

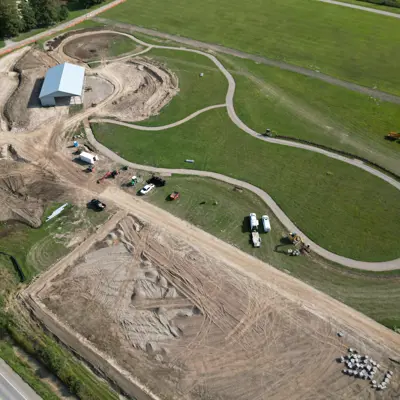

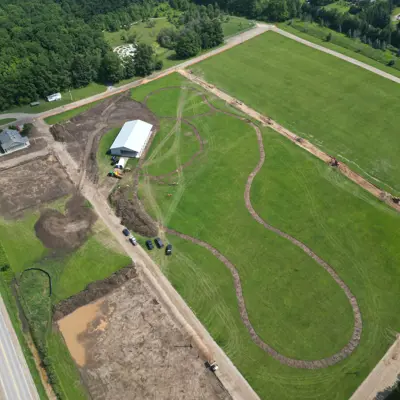

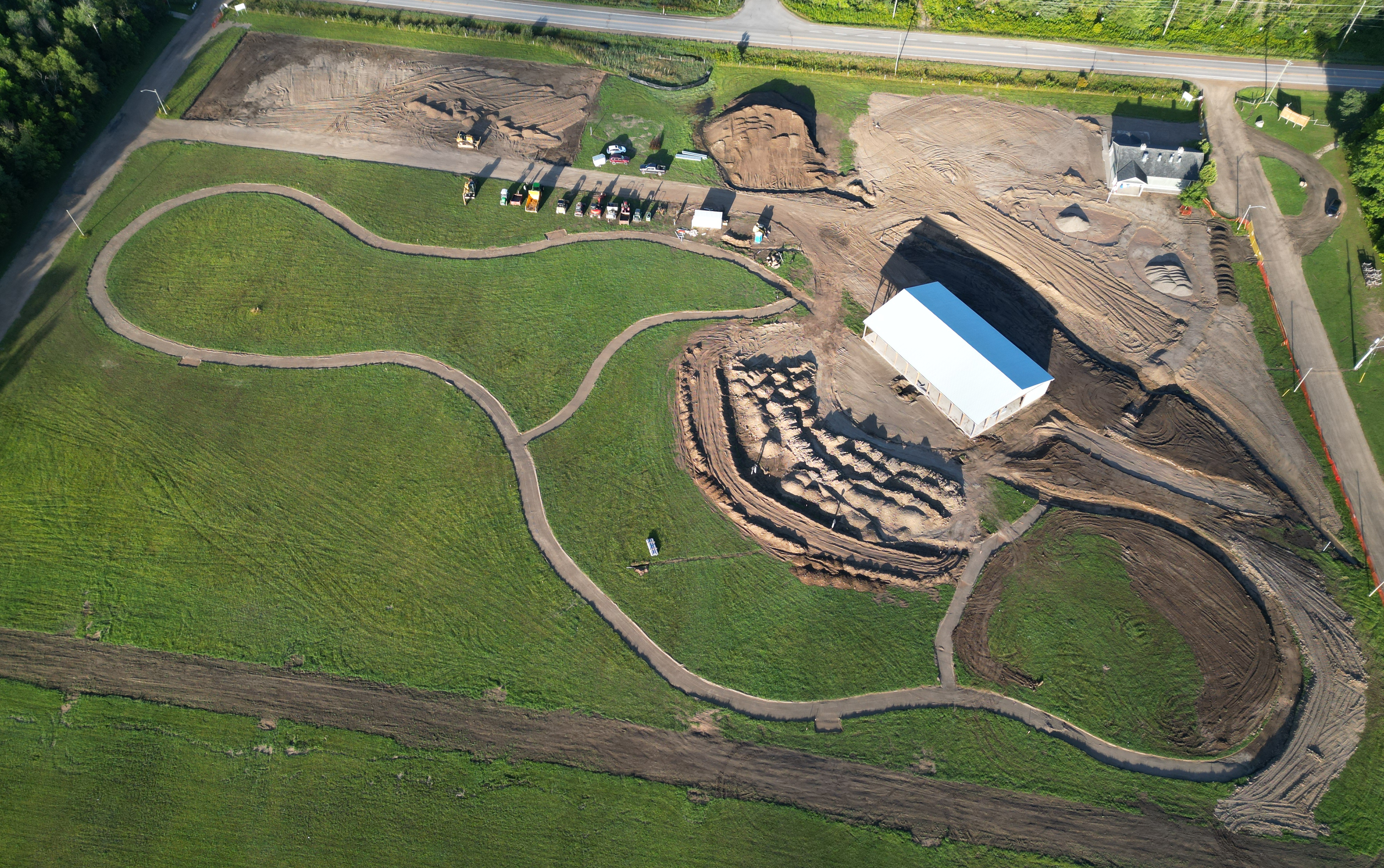

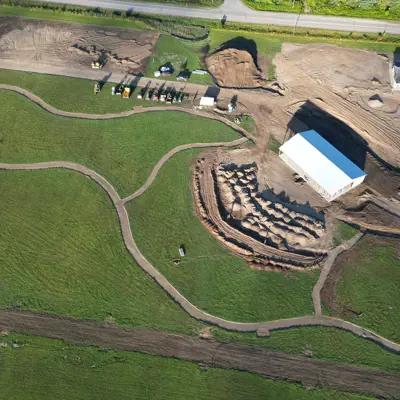

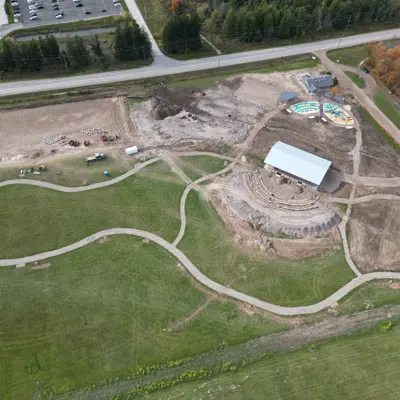

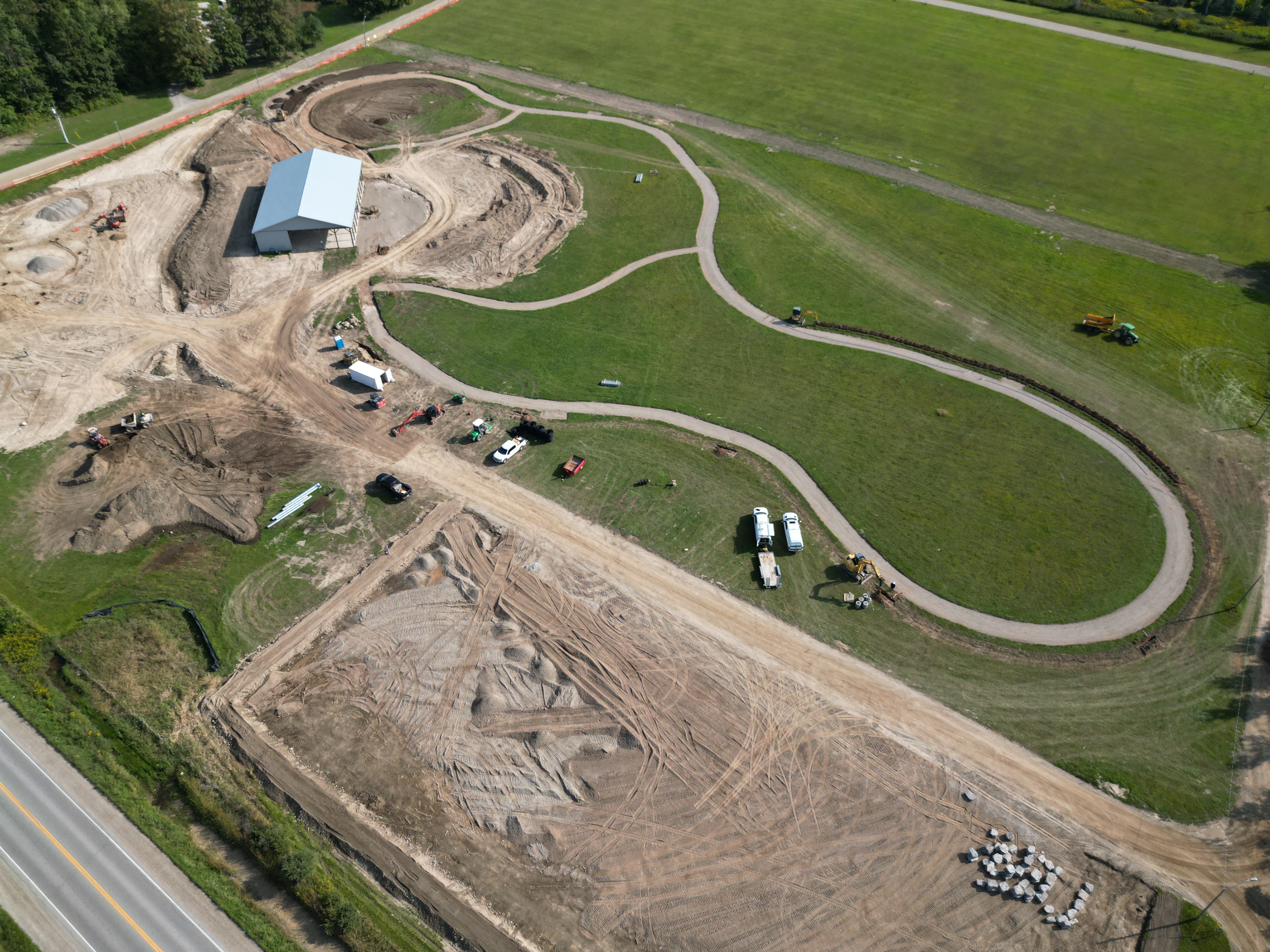

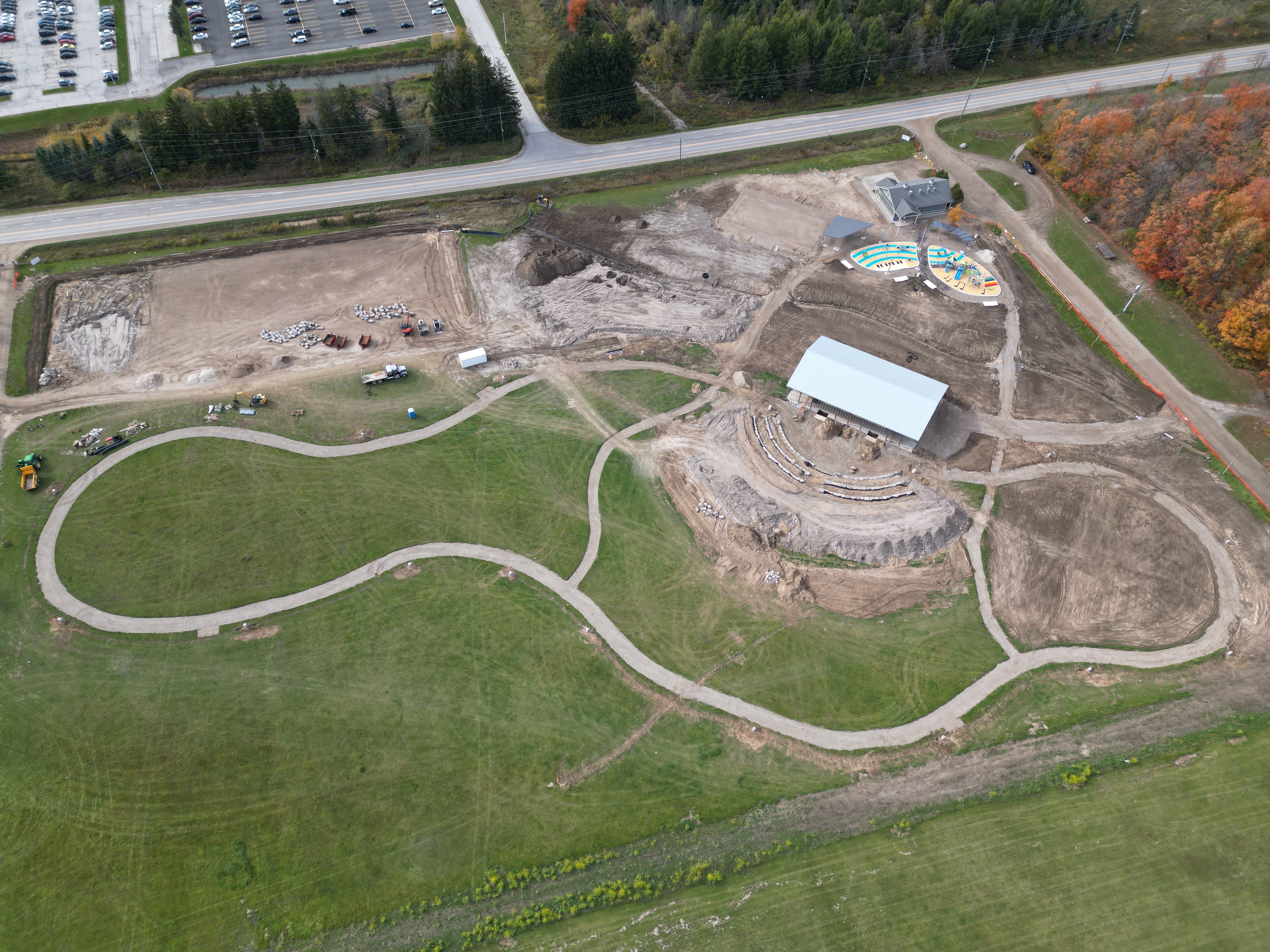

Phase 1 construction timeline is mid May 2025 to mid November 2025. The area of Fiddle Park under construction will be closed to public.

2025 Capital Project

Description

Estimated Expenditure

Funding Score

Resource

Site Preparations & Servicing

$844,464

DC Eligible

PRMP

Professional Fees (GSP & SBA)

$336,000

DC Eligible

PRMP

Basic Grass Parking Lot

$50,080

DC Eligible

PRMP

Pedestrian Circulation & Accessibility Improvements

$104,450

DC Eligible

PRMP

Amphitheatre/Outdoor Classroom & Pavilion Improvements
(Potential Offsetting Grant)

$420,480

DC Eligible

PRMP

Multi-functional Trail

$268,450

DC Eligible  - Reserves

PRMP

Overall Site Furnishings

$89,500

DC Eligible  - Reserves

PRMP

Overall Tree Planting  (Potential Offsetting Grant)

$95,400

DC Eligible  - Reserves

PRMP

* Playground

$422,630

DC Eligible  - Reserves

PRMP

* Basketball Court

$249,620

DC Eligible  - Reserves

PRMP

Mini-Putt (not identified in original phase 1 concept park plan Nov 2023)

$250,000

DC Eligible  - Reserves

NEW FEATURE

20% Contingency

$559,015

DC Eligible

PRMP

* Item moved up from 2027

2025, 2026, 2027 and 2028

Fiddle Park Capital Project – Phase 1 & 2 Summary

Description

Estimated Expenditure

2025 Phase 1

$3,690,089

2026 Phase 2

$523,850

2027 Phase 2

$749,827

2028 Phase 2

$2,379,400

Contact Us

Administrative Office

203 Main Street East
Shelburne, ON L9V 3K7

Email: info@shelburne.ca
Phone: 519-925-2600
Fax: 519 -925-6134

Sign up to our Newsletter

Stay up to date on the town's activities, events, programs and operations by subscribing to our eNewsletters.

This website uses cookies to enhance usability and provide you with a more personal experience. By using this website, you agree to our use of cookies as explained in our Privacy Policy.
